Skip to content
  • There are no suggestions because the search field is empty.

How Changing Resource Group Composition Affects Productivity in Estimator

With the release of Estimator version 2026.0.0.2 in February 2026, we made a significant update to the way resource groups recalculate productivity when a user adjusts the group's composition.

Summary: Adjusting Staff Updates Productivity

In a nutshell, adjusting a resource group's composition now updates the crew's overall productivity while keeping individual unit labor rates constant. This should prove more intuitive to users since the amount of work that a particular person can do should not be inherently impacted by the size of the crew.

The individual efficiency metrics, such as units per man-hour (Unit/MH) and man-hours per unit (MH/Unit), do not change when crew size is modified. Thus, when crew composition changes, the quantity (output per hour) is updated, while the time (man-hours per unit) remains consistent.

Example

In the below resource group, we have a quantity of one for each of the resources:

When this resource group is applied to a line item with a crew productivity of 100sf per hour,  it has a current Unit/MH of 25, and MH/Unit of .04, as shown below:

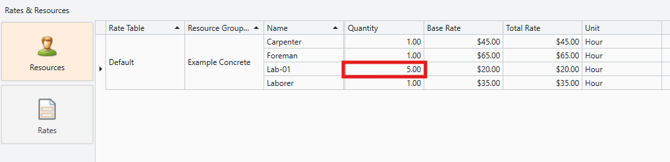

Now, we will change the resource group composition to include 5 Lab-01 resources instead of 1.

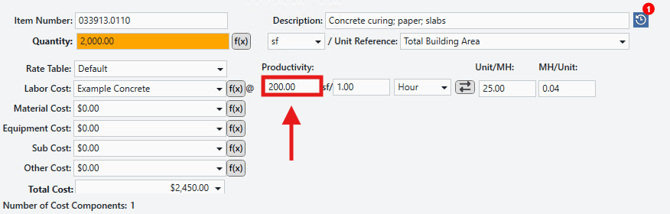

The Cost Information View reflects this update with a recalculated productivity rate of 200sf per hour, while the Unit/MH and MH/Unit remain the same.

Regardless of whether productivity is expressed as time/qty or qty/time, the quantity value is what will be adjusted when escalating, de‑escalating, or changing crew composition.

Submit Your Suggestions to Help Improve This Article
